Offshore Wind
  • Fixed-Bottom
  • Floating Wind
  • Supply Chain
  • Contracts & Tenders
  • Grid Connection
  • More news
JobsNewsletter
Offshore Wind logo

Your trusted source for global offshore wind news, part of the Navingo network.

Topics
  • Fixed-Bottom
  • Floating Wind
  • Grid Connection
  • Power-to-X
  • Supply Chain
Network
  • Offshore Wind
  • Dredging Today
  • NavalToday
  • Offshore Energy
  • Maritieme Vacaturebank
Company
  • Advertising
  • Newsletter
  • Jobs
  • Report your news
  • Privacy

© 2026 Navingo. All rights reserved.

Home›Wind Farm Update›Vole au vent Sets Off to Begin CVOW Construction
Wind Farm Update

May 21, 2020 · about 6 years ago

Vole au vent Sets Off to Begin CVOW Construction

Jan De Nul’s jack-up vessel Vole au vent has departed from the Port of Halifax, Canada, with the first batch of turbine components for the Coastal Virginia Offshore Wind (CVOW) demonstration project. Photos available on social media show the vessel carrying the monopile foundation components destine

1 minutes read
  • LinkedIn
  • X
  • Email
Vole au vent Sets Off to Begin CVOW Construction
Jan De Nul/Illustration

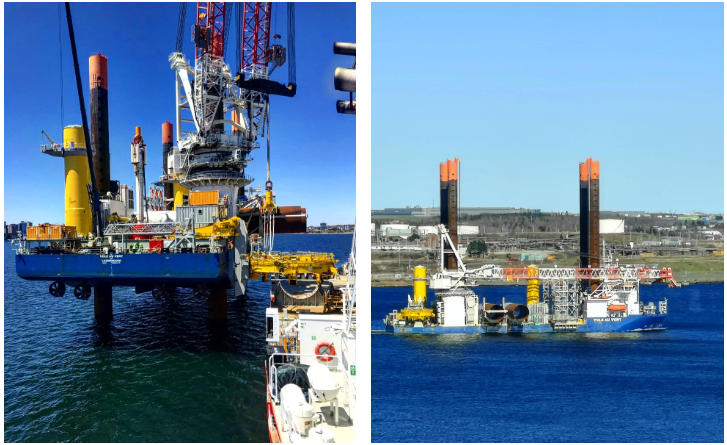

Jan De Nul’s jack-up vessel Vole au vent has departed from the Port of Halifax, Canada, with the first batch of turbine components for the Coastal Virginia Offshore Wind (CVOW) demonstration project.

Photos available on social media show the vessel carrying the monopile foundation components destined for the 12 MW project.

Vole au vent started its journey from Halifax on 20 May at around 18:20 local time and is expected to arrive at CVOW on 24 May in the afternoon.

The jack-up will reportedly return to Halifax two more times, to load the turbine towers in the second trip and then to load the nacelles and the blades in the third return.

The turbine components and monopile foundations arrived in Halifax in late April.

CVOW, developed by Ørsted and Dominion Energy, will comprise two Siemens Gamesa 6 MW turbines installed some 27 miles off the coast of Virginia Beach.

The two turbines are expected to provide the operational, weather, and environmental experience needed for the 2.6 GW development in the adjacent 112,800 ha lease site, expected to be operational by 2026.

Subsea 7 recently completed a cable pull-in at Camp Pendelton for the demo project.

Reach the Offshore Wind industry in one go!

Offshore Wind is read by thousands of professionals every day.

Increase your visibility with banners, tell your story with a branded article, and showcase your expertise with a full-page company profile in our business directory.

CONTACT

Follow Offshore Wind on:

Filed under

Wind Farm Update

Daily Offshore Wind News in Your Mailbox

Join thousands of industry professionals who start their day with our newsletter.

Trending Now

  1. 1DNV Certifies Floating Wind Turbine Foundation Design for Buchan Project
  2. 2Vestas Partners with Deepwater Wind Technology Developer
  3. 3All Turbines Installed at Poland's First Offshore Wind Farm
  4. 4Sumitomo Teams Up with Irish Floating Wind Mooring Tech Company

Daily Offshore Wind News in Your Mailbox

Join thousands of industry professionals who start their day with our newsletter.

Subscribe free
