The East Anglia ONE wind farm project has complied with all the Operational Conditions Precedent (OCPs) to begin receiving payments under the Contracts for Difference scheme in the United Kingdom, Iberdrola said.
The added capacity at East Anglia ONE has increased Iberdrola’s installed offshore wind capacity by 77.1% year-on-year, from 544MW at the end of 2018 to 964MW at the end of 2019, Iberdrola said in its financial report for the Fiscal Year 2019.
The difference of 420MW suggests that 60 out of the 102 wind turbines were installed at the wind farm by the end of 2019.
East Anglia ONE delivered the first power to the UK grid in early September 2019.
The partial commissioning of East Anglia ONE and the full commissioning of the 350MW Wikinger in the German Baltic Sea helped Iberdrola increase its offshore wind production by 34.7% year-on-year, from 1,642 GWh in 2018 to 2,211 GWh in 2019.
Iberdrola also operates the 194MW West of Duddon Sands wind farm in the UK waters.

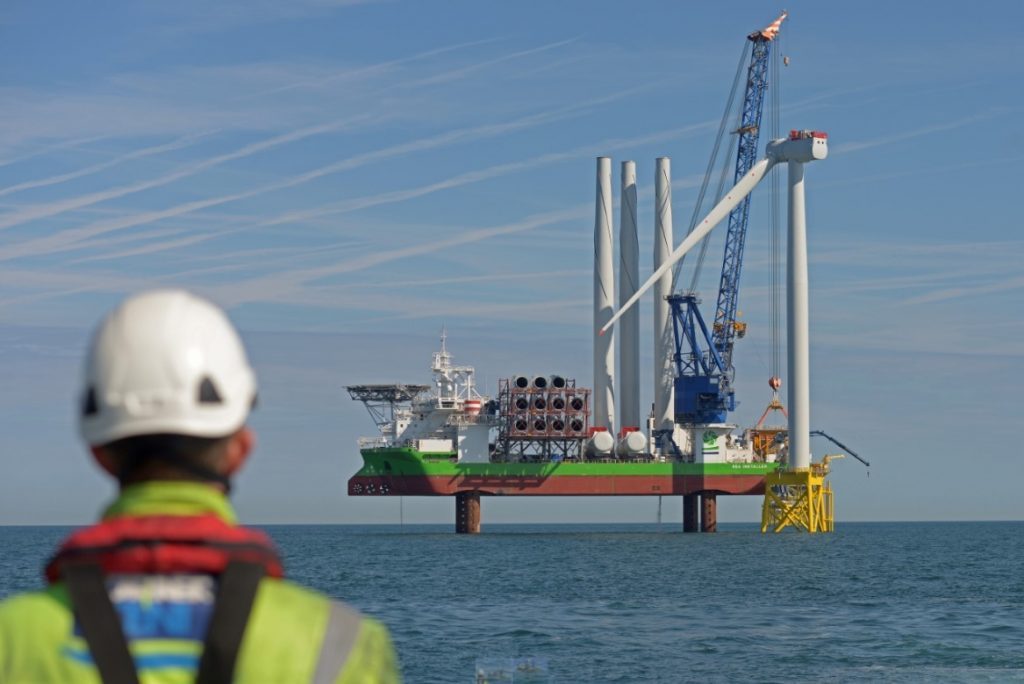

Photo: Iberdrola
List of related news articles
-
Posted: 24 days ago
Ofgem Selects Preferred East Anglia 1 Transmission Operator
UK energy market regulator Ofgem has named Transmission Capital Partners the preferred offshore tran...
Posted: 24 days ago -
Posted: 2 months ago
CWind Done at East Anglia One for This Year
CWind has completed this year’s campaign at the East Anglia One offshore wind farm in the UK. ...
Posted: 2 months ago -
Posted: 2 months ago
TRIG Takes Stake in East Anglia ONE
The Renewables Infrastructure Group Limited (TRIG) has agreed to acquire a 14.3 per cent indirect eq...
Posted: 2 months ago -
Posted: 6 months ago
East Anglia One Now Officially Fully Operational
The final phase of East Anglia One has started to receive payments under the project’s Contract for ...
Posted: 6 months ago
