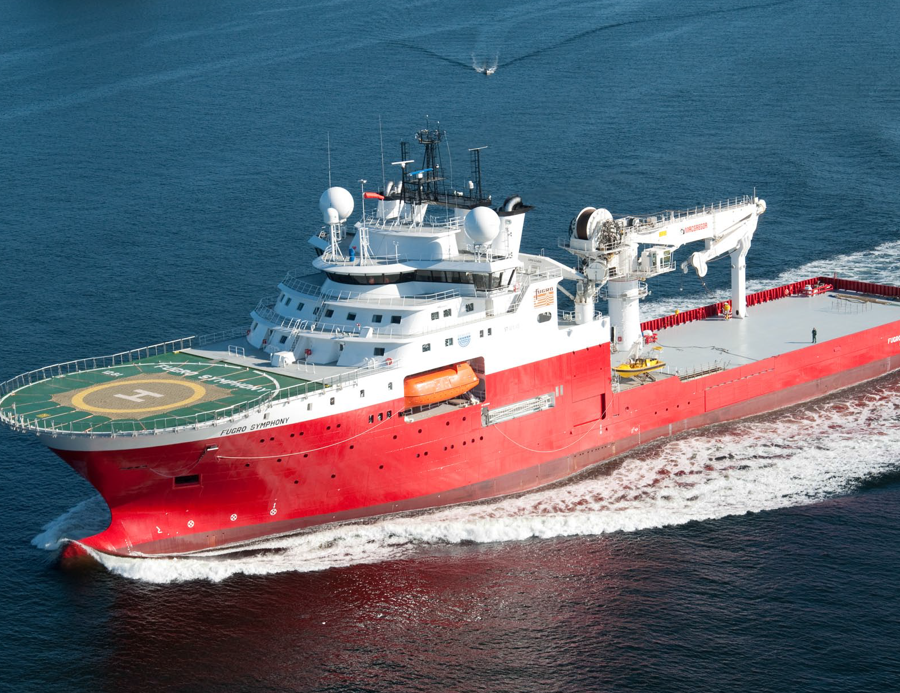

Fugro’s multi-purpose offshore vessel Fugro Symphony will return to the 400MW Rampion offshore wind farm next week to install the remaining inter-array cables at the site located some 13 kilometres off the Sussex coast.
During the first phase of the project, which started in August 2016 and ended in November 2016, Fugro Symphony and Fugro Saltire transported installed and buried the first 60 inter-array cables at the site.
Starting on Friday, 7 April, Fugro Symphony will start working on the remaining 62 inter-array cables, according to a notice to mariners. The second phase of the project is expected to be completed by summer.
Fugro Saltire will be in charge of cable burial works during the second phase of the project.
The GBP 1.3 billion Rampion is being built by E.ON, the UK Green Investment Bank plc and Canadian energy company Enbridge.
The wind farm will comprise 116 3.45MW MHI Vestas turbines, the first of which was installed earlier this month.
The project is due to be completed and fully operational in 2018.
Photo: Source: Noryards
List of related news articles
-
Posted: 11 days ago
Inter-Array Cable Installation Starts at Windpark Fryslân
Van Oord has started installing inter-array cables at the Windpark Fryslân nearshore wind farm in th...
Posted: 11 days ago -
Posted: about 1 month ago
EnBW Issues He Dreiht Inter-Array Cable Contract Call
German energy company EnBW Energie Baden-Württemberg AG has issued a call for the turnkey supply of ...
Posted: about 1 month ago -
Posted: about 1 month ago
All Saint-Brieuc Inter-Array Cables to Be Buried
Ailes Marines reported on 2 December that all the inter-array cables at the Saint-Brieuc offshore wi...
Posted: about 1 month ago -
Posted: 7 hours ago
Rampion 2 Team Starts Informal Consultation
The Rampion 2 team has launched a four-week informal consultation this week to raise awareness and s...
Posted: 7 hours ago
