Offshore Wind
  • Fixed-Bottom
  • Floating Wind
  • Supply Chain
  • Contracts & Tenders
  • Grid Connection
  • More news
JobsNewsletter
Offshore Wind logo

Your trusted source for global offshore wind news, part of the Navingo network.

Topics
  • Fixed-Bottom
  • Floating Wind
  • Grid Connection
  • Power-to-X
  • Supply Chain
Network
  • Offshore Wind
  • Dredging Today
  • NavalToday
  • Offshore Energy
  • Maritieme Vacaturebank
Company
  • Advertising
  • Newsletter
  • Jobs
  • Report your news
  • Privacy

© 2026 Navingo. All rights reserved.

Home›Fixed-Bottom›Saipem 7000, Seaway Strashnov to Begin Dogger Bank B Offshore Construction Work
Fixed-Bottom

April 9, 2024 · about 2 years ago

Saipem 7000, Seaway Strashnov to Begin Dogger Bank B Offshore Construction Work

The installation of the offshore substation topside and monopile foundations is about to commence at Dogger Bank B offshore wind farm, the second of the three 1.2 GW phases of the 3.6 GW Dogger Bank Wind Farm in the UK. Installation vessels Saipem 7000 and Seaway Strashnov are expected to arrive at

3 minutes read
  • LinkedIn
  • X
  • Email

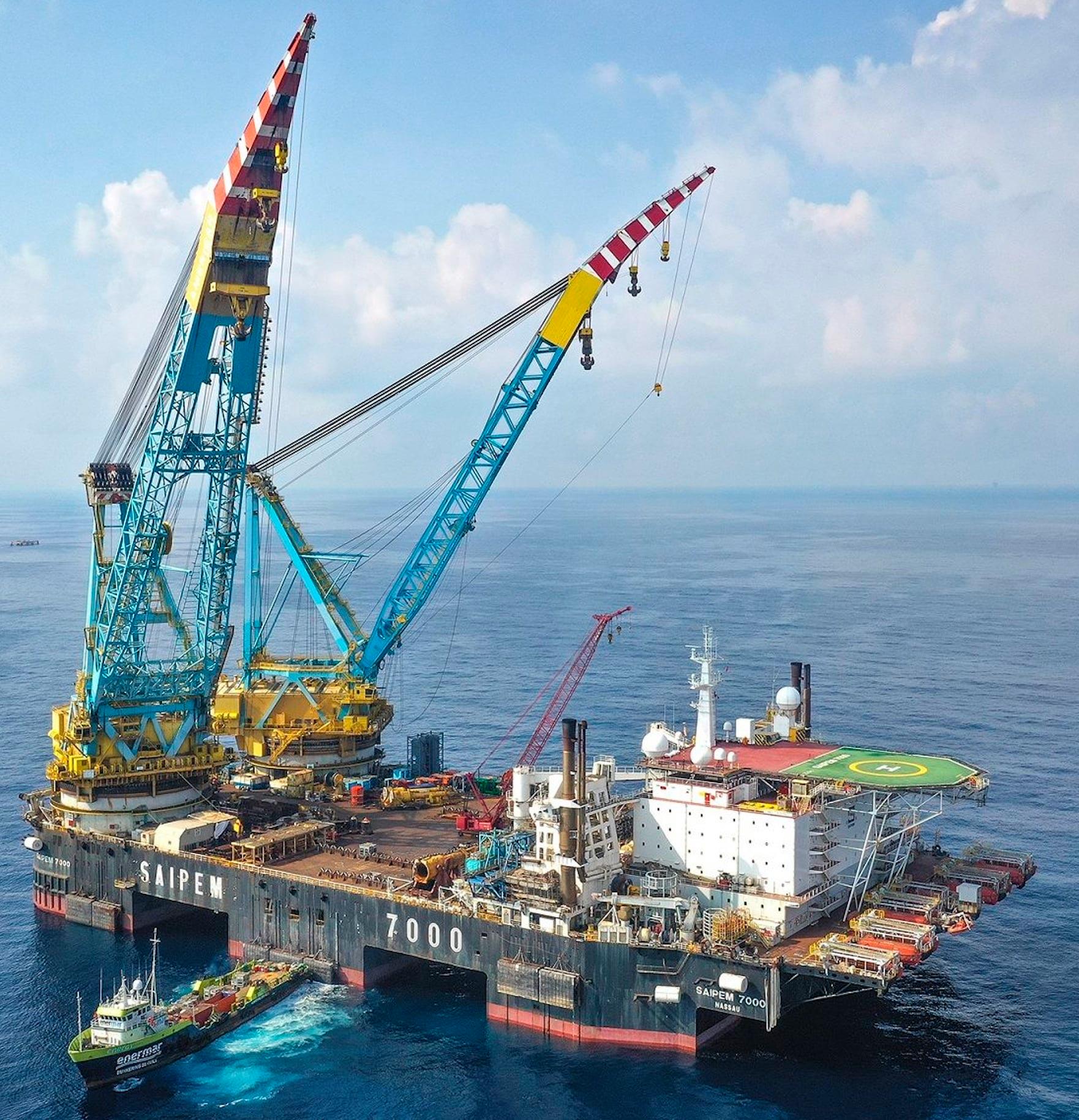

Saipem 7000, Seaway Strashnov to Begin Dogger Bank B Offshore Construction Work
Saipem/Illustration

The installation of the offshore substation topside and monopile foundations is about to commence at Dogger Bank B offshore wind farm, the second of the three 1.2 GW phases of the 3.6 GW Dogger Bank Wind Farm in the UK.

Installation vessels Saipem 7000 and Seaway Strashnov are expected to arrive at the project site in the coming days and start construction work, as are HEA Leviathan and Edda Boreas which will be deployed for the commissioning of the offshore substation (OSS) and underwater noise monitoring, respectively.

According to AIS data available online, Saipem 7000 is en route from Norway to the Dogger Bank B site, where the vessel will install the OSS topside on the jacket foundation that was installed last year . The topside is being transported to the site onboard the cargo barge Castoro XI which is being towed by the anchor-handling tug (AHT) Pacific Discovery .

The installation of the topside is expected to take until 18 April, when the commissioning will begin from the jack-up vessel HEA Leviathan (formerly Seajacks Leviathan ), which will be providing accommodation during the work that will be taking place until mid-August.

The jack-up vessel Seaway Strashnov is scheduled to arrive around the time the OSS topside is in place and commence monopile installation, with the company Subacoustech Environmental set to perform underwater noise (UWN) monitoring during the installation of the first five monopiles using the service operations vessel (SOV) Edda Boreas .

As reported in January, monopile installation on the 1.2 GW Dogger Bank B was scheduled to start in September 2023, but the campaign was delayed.

Related Articles

Equipment

Monopile Installation on Dogger Bank B Delayed by Six Months

3 min read

According to a filing by the Dogger Bank Wind Farm consortium with the UK’s Marine Management Organisation (MMO) in November 2023, “unavoidable piling delays were incurred after a mechanical fault in the monopile lifting tool was discovered following the Dogger Bank A (DBA) foundation installation campaign” and, at the time, the installation vessel Seaway Strashnov demobilised for planned maintenance, after which it was contracted for a separate job in Angola over the winter period.

In a Notice to Mariners dated 6 April, the Dogger Bank Wind Farm project team says the monopile installation will run until approximately the third quarter of this year.

AIS data for Seaway Strashnov is currently showing the vessel in Maasvlakte in the port of Rotterdam.

For Dogger Bank B, the foundations are being delivered by the consortium of Sif Netherlands and Smulders Projects Belgium , under a contract the companies signed in 2020 for the first two phases of the Dogger Bank Wind Farm.

The first two 1.2 GW phases of the Dogger Bank Wind Farm, Dogger Bank A and Dogger Bank B, will comprise 95 Haliade-X 13 MW turbines each. The third phase, Dogger Bank C, will feature 87 Haliade-X 14 MW turbines.

Dogger Bank A is currently in the wind turbine installation stage and has already produced the first power last year.

Jan De Nul’s vessel Voltaire installed the first of the 95 Haliade-X 13 MW turbines at the Dogger Bank A site in September 2023 and has since installed eleven more, before leaving for scheduled maintenance in Vlissingen. The vessel is expected to resume work in May .

Reach the Offshore Wind industry in one go!

Offshore Wind is read by thousands of professionals every day.

Increase your visibility with banners, tell your story with a branded article, and showcase your expertise with a full-page company profile in our business directory.

CONTACT

Follow Offshore Wind on:

Filed under

Fixed-BottomProject UpdatesVesselsWind Farm Update

Daily Offshore Wind News in Your Mailbox

Join thousands of industry professionals who start their day with our newsletter.

Trending Now

  1. 1Ofgem to Launch Record Tender as UK Regulator Seeks Owner of Hornsea 3 Offshore Transmission Assets
  2. 2French Engineering Company Acquires Irish Sea Contractors to Expand Offshore Wind and Cable Services
  3. 3Pacifico Energy Launches Survey Campaign for 1.8 GW Offshore Wind Projects in Vietnam
  4. 4Inter-Array Cable Installation About to Start at 2.9 GW UK Offshore Wind Farm

Daily Offshore Wind News in Your Mailbox

Join thousands of industry professionals who start their day with our newsletter.

Subscribe free
