Offshore Wind
  • Fixed-Bottom
  • Floating Wind
  • Supply Chain
  • Contracts & Tenders
  • Grid Connection
  • More news
JobsNewsletter
Offshore Wind logo

Your trusted source for global offshore wind news, part of the Navingo network.

Topics
  • Fixed-Bottom
  • Floating Wind
  • Grid Connection
  • Power-to-X
  • Supply Chain
Network
  • Offshore Wind
  • Dredging Today
  • NavalToday
  • Offshore Energy
  • Maritieme Vacaturebank
Company
  • Advertising
  • Newsletter
  • Jobs
  • Report your news
  • Privacy

© 2026 Navingo. All rights reserved.

Home›Grid Connection›Saint-Nazaire Foundation Installation to Begin End of March
Grid Connection

February 23, 2021 · about 5 years ago

Saint-Nazaire Foundation Installation to Begin End of March

The first transition pieces for the Saint-Nazaire offshore wind project in France have arrived at the Port of La Rochelle. Smulders shipped off the first four transition pieces for the 480 MW project in mid-February from Belgium to Rotterdam, the Netherlands, from where they were transported to Fran

1 minutes read
  • LinkedIn
  • X
  • Email
Saint-Nazaire-Foundation-Installation-to-Begin-End-of-March
Smulders

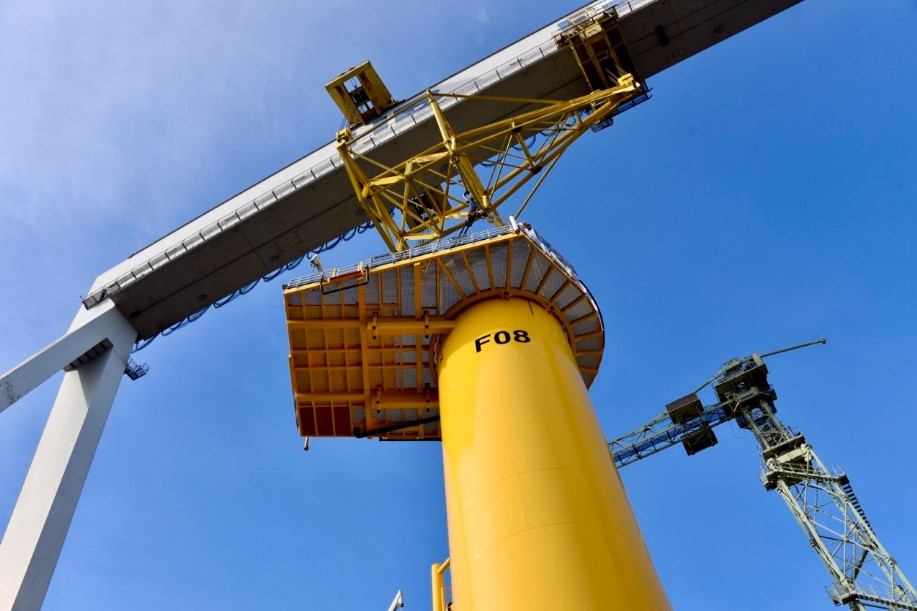

The first transition pieces for the Saint-Nazaire offshore wind project in France have arrived at the Port of La Rochelle.

Smulders shipped off the first four transition pieces for the 480 MW project in mid-February from Belgium to Rotterdam, the Netherlands, from where they were transported to France.

DEME’s jack-up vessel Innovation is expected to begin installing the foundations at the offshore site at the end of March.

Additionally, Prysmian began the production of inter-array cables in Gron and Montereau-Fault-Yonne. The first steps which include wire drawing and stranding began in January.

Saint-Nazaire , also known as Parc du Banc de Guérande, will comprise 80 GE Haliade 150-6MW turbines located between 12 and 20 km off the coast of the Guérande peninsula.

Sif is in charge of producing the 80 monopiles and primary steel for the 80 transition pieces under an order placed by Eiffage Métal.

The 480 MW project is scheduled to be operational in the summer of 2022 when it will become the first commercial-scale wind farm installed in French waters.

Reach the Offshore Wind industry in one go!

Offshore Wind is read by thousands of professionals every day.

Increase your visibility with banners, tell your story with a branded article, and showcase your expertise with a full-page company profile in our business directory.

CONTACT

Follow Offshore Wind on:

Filed under

Grid ConnectionWind Farm Update

Daily Offshore Wind News in Your Mailbox

Join thousands of industry professionals who start their day with our newsletter.

Trending Now

  1. 1Balfour Beatty Wins Contract for Substation to Connect Three Dogger Bank Wind Farms
  2. 2Archer Weighs Sale of Offshore Wind Business After Culzean Project Setbacks
  3. 3Vattenfall Tests New Bird Monitoring Tech at Dutch Offshore Wind Farm
  4. 4IFM Investors to Acquire Majority Stake in UK Port Operator ABP

Daily Offshore Wind News in Your Mailbox

Join thousands of industry professionals who start their day with our newsletter.

Subscribe free
