Offshore Wind
  • Fixed-Bottom
  • Floating Wind
  • Supply Chain
  • Contracts & Tenders
  • Grid Connection
  • More news
JobsNewsletter
Offshore Wind logo

Your trusted source for global offshore wind news, part of the Navingo network.

Topics
  • Fixed-Bottom
  • Floating Wind
  • Grid Connection
  • Power-to-X
  • Supply Chain
Network
  • Offshore Wind
  • Dredging Today
  • NavalToday
  • Offshore Energy
  • Maritieme Vacaturebank
Company
  • Advertising
  • Newsletter
  • Jobs
  • Report your news
  • Privacy

© 2026 Navingo. All rights reserved.

Home›Wind Farm Update›SeaTerra: All Clear at Trianel Windpark Borkum II
Wind Farm Update

March 14, 2018 · about 8 years ago

SeaTerra: All Clear at Trianel Windpark Borkum II

On 12 March, SeaTerra detonated the last buoyant mine found at the Trianel Windpark Borkum II (TWB II) site as part of an unexploded ordnance (UXO) campaign that had been running over the recent months, thus marking the completion of the project.

2 minutes read
  • LinkedIn
  • X
  • Email

On 12 March, SeaTerra detonated the last buoyant mine found at the Trianel Windpark Borkum II (TWB II) site as part of an unexploded ordnance (UXO) campaign that had been running over the recent months, thus marking the completion of the project.

As part of the required UXO survey and target investigation, SeaTerra identified eleven major UXO targets, including seven buoyant mines, two ground mines, one depth charge and one bomb.

The ordnance targets were not transportable, so the company’s explosives specialists and ordnance divers had to demolish them in situ. All demolitions were thoroughly prepared and designed in close cooperation with the responsible regulators, and marine mammals protected by scaring devices and a “Big Bubble Curtain” to minimise noise, SeaTerra pointed out.

Prior to the ordnance clearance works, the company performed comprehensive geophysical surveys across 427 hectares of the seabed, covering wind turbine locations, infield cable routes and anchor areas. The surveys had been carried out with high-resolution magnetometers utilising array systems (ROTV) or remote operated vehicles (ROV). Subsequent data interpretation led to the identification of hundreds of anomalies, of which SeaTerra identified 288 as potentially dangerous objects, which were then investigated and cleared with the help of remote-controlled devices (ROV, airlift), cranes and ordnance divers.

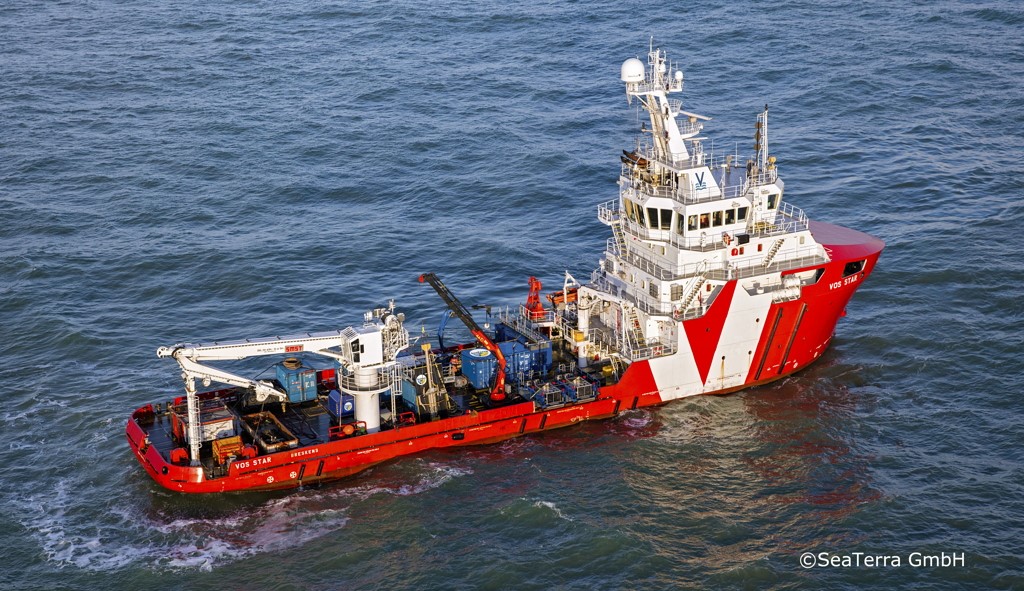

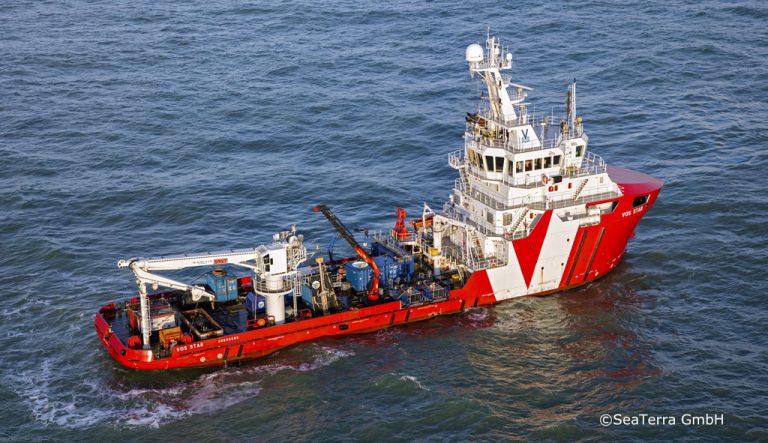

For the UXO campaign at TWB II, SeaTerra used the vessels Mimer (ROTV survey), Vos Star (ROV survey and target investigation) and Olympic Challenger (target investigation).

The construction of TWB II is expected to start soon at the project site approximately 40 kilometres north of the island of Borkum, within the German sector of the North Sea. The wind farm’s 32 Senvion 6.2M152 turbines are scheduled to be connected to the grid by the end of 2019.

Reach the Offshore Wind industry in one go!

Offshore Wind is read by thousands of professionals every day.

Increase your visibility with banners, tell your story with a branded article, and showcase your expertise with a full-page company profile in our business directory.

CONTACT

Follow Offshore Wind on:

Filed under

Wind Farm Update

Daily Offshore Wind News in Your Mailbox

Join thousands of industry professionals who start their day with our newsletter.

Trending Now

  1. 1GWEC Calls for Government Action to Accelerate Floating Wind Commercialisation
  2. 2France Energies Marines Launches Four Offshore Wind R&D Projects
  3. 3DNV Certifies Floating Wind Turbine Foundation Design for Buchan Project
  4. 4Vestas Partners with Deepwater Wind Technology Developer

Daily Offshore Wind News in Your Mailbox

Join thousands of industry professionals who start their day with our newsletter.

Subscribe free
