Advertisement

Wind Farm Update

about 9 years ago

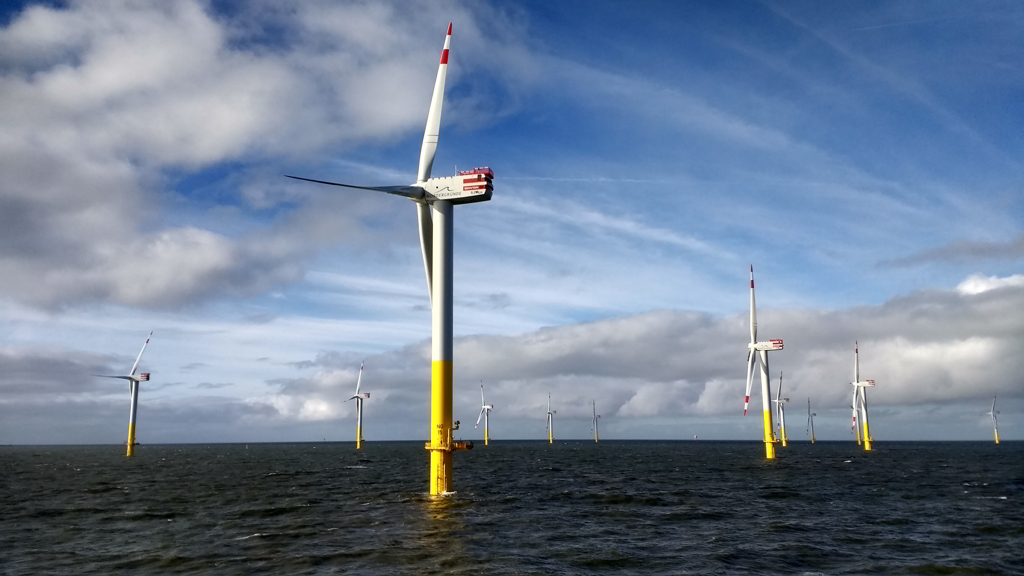

Last Nordergründe Turbine Hooked to the Grid, Offshore Wind Farm Goes Live

The 111MW Nordergründe offshore wind farm is now officially in full operation, after the last of the total of 18 Senvion 6.2M126 wind turbines was connected to the grid yesterday, 17 December.

1 minutes read

The 111 MW Nordergründe offshore wind farm is now officially in full operation, after the last of the total of 18 Senvion 6.2M126 wind turbines was connected to the grid on 17 December.

This final milestone for the project was delayed for a year after BVT, the company in charge of building the substation, entered insolvency in the third quarter of 2016, and the remaining works on the substation were later carried out by several subcontractors.

The substation was installed in the second half of September 2017, with TenneT commissioning the grid connection for the Nordergründe offshore wind farm on 31 October .

In addition to wpd, the co-shareholders of the Nordergründe offshore wind farm are John Laing Group plc and the Gothaer Insurance Group.

Reach the Offshore Wind industry in one go!

Offshore Wind is read by thousands of professionals every day.

Increase your visibility with banners, tell your story with a branded article, and showcase your expertise with a full-page company profile in our business directory.

CONTACT

Follow Offshore Wind on:

Daily Offshore Wind News in Your Mailbox

Join thousands of industry professionals who start their day with our newsletter.
