Offshore Wind
  • Fixed-Bottom
  • Floating Wind
  • Supply Chain
  • Contracts & Tenders
  • Grid Connection
  • More news
JobsNewsletter
Offshore Wind logo

Your trusted source for global offshore wind news, part of the Navingo network.

Topics
  • Fixed-Bottom
  • Floating Wind
  • Grid Connection
  • Power-to-X
  • Supply Chain
Network
  • Offshore Wind
  • Dredging Today
  • NavalToday
  • Offshore Energy
  • Maritieme Vacaturebank
Company
  • Advertising
  • Newsletter
  • Jobs
  • Report your news
  • Privacy

© 2026 Navingo. All rights reserved.

Home›Grid Connection›DONG Energy Preparing for Race Bank’s Cable Connection
Grid Connection

April 6, 2016 · about 10 years ago

DONG Energy Preparing for Race Bank’s Cable Connection

Works on connecting Race Bank wind farm’s offshore cables to the ones on land at a landfall site north of Sutton Bridge should start this month, DONG Energy reported in its project newsletter. Landfall works will be done with a specific approach, since the area comprises a saltmarsh and a sea defenc

2 minutes read
  • LinkedIn
  • X
  • Email

Works on connecting Race Bank wind farm’s offshore cables to the ones on land at a landfall site north of Sutton Bridge should start this month, DONG Energy reported in its project newsletter.

Landfall works will be done with a specific approach, since the area comprises a saltmarsh and a sea defence bank. DONG Energy has developed the site-specific approach together with specialist contractors Mott MacDonald and Jan De Nul.

Following sea defence preparation works, two cable laying machines, designed by Jan De Nul and called Sunfish and Moonfish, will arrive on a barge to lay and install both the East and West cables. The installation of each of the cables will last for five days.

Sunfish will track toward the sea defence whilst laying cable rollers. Once it reaches the foot of the sea defence, it will pull the cable from the offshore barge toward the sea defence with the help of a winch. It will then return offshore to the barge, while simultaneously installing the cable 1.5 metres below ground level.

When Sunfish reaches Moonfish in the intertidal area, it will temporarily return to the barge to await the laying of the second cable, while Moonfish will continue to install the cable across the intertidal mudflats.

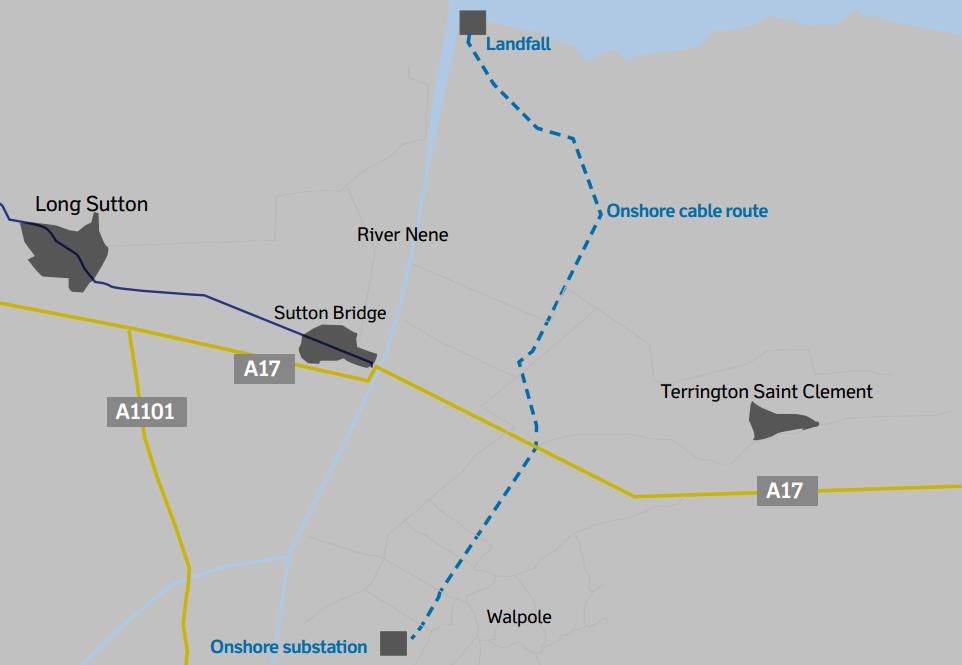

Onshore construction for the Race Bank offshore wind project began in early 2015 with an onshore substation and the onshore cable works, which are now nearing completion.

The offshore wind farm, which will consist of up to 91 wind turbines, is located almost 17 miles off Blakeney Point on the North Norfolk Coast.

Offshore construction is due to begin later this year and the project is expected to become operational in 2018.

Reach the Offshore Wind industry in one go!

Offshore Wind is read by thousands of professionals every day.

Increase your visibility with banners, tell your story with a branded article, and showcase your expertise with a full-page company profile in our business directory.

CONTACT

Follow Offshore Wind on:

Filed under

Grid ConnectionWind Farm Update

Daily Offshore Wind News in Your Mailbox

Join thousands of industry professionals who start their day with our newsletter.

Trending Now

  1. 1US Gov’t Seeks New Review of US Wind’s Maryland Project
  2. 2Former RWE Offshore Wind CEO Joins Esvagt Board
  3. 3UK’s First HVDC Subsea Cable Factory Opens in Scotland
  4. 4Diverse Marine to Build Three More CTVs for OEG

Daily Offshore Wind News in Your Mailbox

Join thousands of industry professionals who start their day with our newsletter.

Subscribe free
