Offshore Wind
  • Fixed-Bottom
  • Floating Wind
  • Supply Chain
  • Contracts & Tenders
  • Grid Connection
  • More news
JobsNewsletter
Offshore Wind logo

Your trusted source for global offshore wind news, part of the Navingo network.

Topics
  • Fixed-Bottom
  • Floating Wind
  • Grid Connection
  • Power-to-X
  • Supply Chain
Network
  • Offshore Wind
  • Dredging Today
  • NavalToday
  • Offshore Energy
  • Maritieme Vacaturebank
Company
  • Advertising
  • Newsletter
  • Jobs
  • Report your news
  • Privacy

© 2026 Navingo. All rights reserved.

Home›Environment›Residents Disturbed by Noise from Kentish Flats Extension
Environment

May 18, 2015 · about 11 years ago

Residents Disturbed by Noise from Kentish Flats Extension

Some residents have experienced disturbance from the piling work currently undertaken 7km offshore Herne Bay and Whitstable in Kent. The Swedish energy giant, Vattenfall, is currently installing foundations at the 49.5MW Kentish Flats Extension offshore wind farm comprising 15 turbines. Adam Ezzamel

2 minutes read
  • LinkedIn
  • X
  • Email

Some residents have experienced disturbance from the piling work currently undertaken 7km offshore Herne Bay and Whitstable in Kent.

The Swedish energy giant, Vattenfall, is currently installing foundations at the 49.5MW Kentish Flats Extension offshore wind farm comprising 15 turbines.

Adam Ezzamel, Foundations Package Manager, pointed out the reasons behind noisy work at different times throughout the day and night.

“First and foremost when we planned our initial schedule we had to work within timing restrictions imposed by the Marine Management Organisation which stated that we could not construct during the herring spawning season. This restriction officially ended on 30 April,” said Ezzamel.

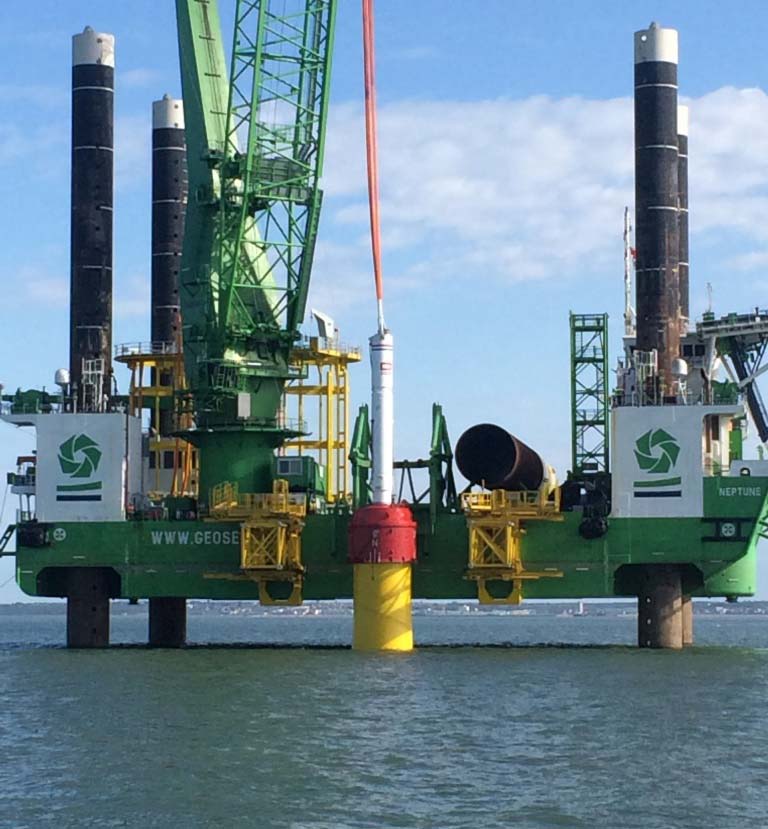

Working in a tidal area, GeoSea’s offshore wind installation vessel, Neptune, can only be positioned in slack water to ensure the safety of the operation and the workforce on board.

After this, the vessels needs to return to Sheerness to reload two foundations which is also a time-consuming process as it needs to be towed by tugs into the harbour. The loading of components is also dependent on weather conditions.

“All these issues make it difficult to plan exactly when we can pile. Of course, the preference would be to only work days but this would have the potential for huge delays if we have to co-ordinate daylight hours, tides and weather windows. It would also extend the disruption to fishermen and other water users which we have tried to avoid. Working offshore is unique, very unpredictable and we have to therefore make use of available opportunities to conclude works as soon as possible, ” added Ezzamel .

Two more installations will be carried out today while the company believes the three remaining foundations to be installed by the end of the week.

Reach the Offshore Wind industry in one go!

Offshore Wind is read by thousands of professionals every day.

Increase your visibility with banners, tell your story with a branded article, and showcase your expertise with a full-page company profile in our business directory.

CONTACT

Follow Offshore Wind on:

Filed under

Environment

Daily Offshore Wind News in Your Mailbox

Join thousands of industry professionals who start their day with our newsletter.

Trending Now

  1. 1Fugro Completes 2026 Survey Campaign for Ireland’s 900 MW Offshore Wind Project
  2. 2Nexans Starts Manufacturing 525 kV Subsea Cables for LanWin2 Offshore Wind Grid Connection
  3. 3All Turbines Installed and Generating Power at Taiwan’s 1 GW Offshore Wind Farm
  4. 4Canada Pledges CAD 100 Million to Advance Nova Scotia’s Offshore Wind

Daily Offshore Wind News in Your Mailbox

Join thousands of industry professionals who start their day with our newsletter.

Subscribe free
