Trianel Wind Farm Borkum Commissioning Pushed to 2015

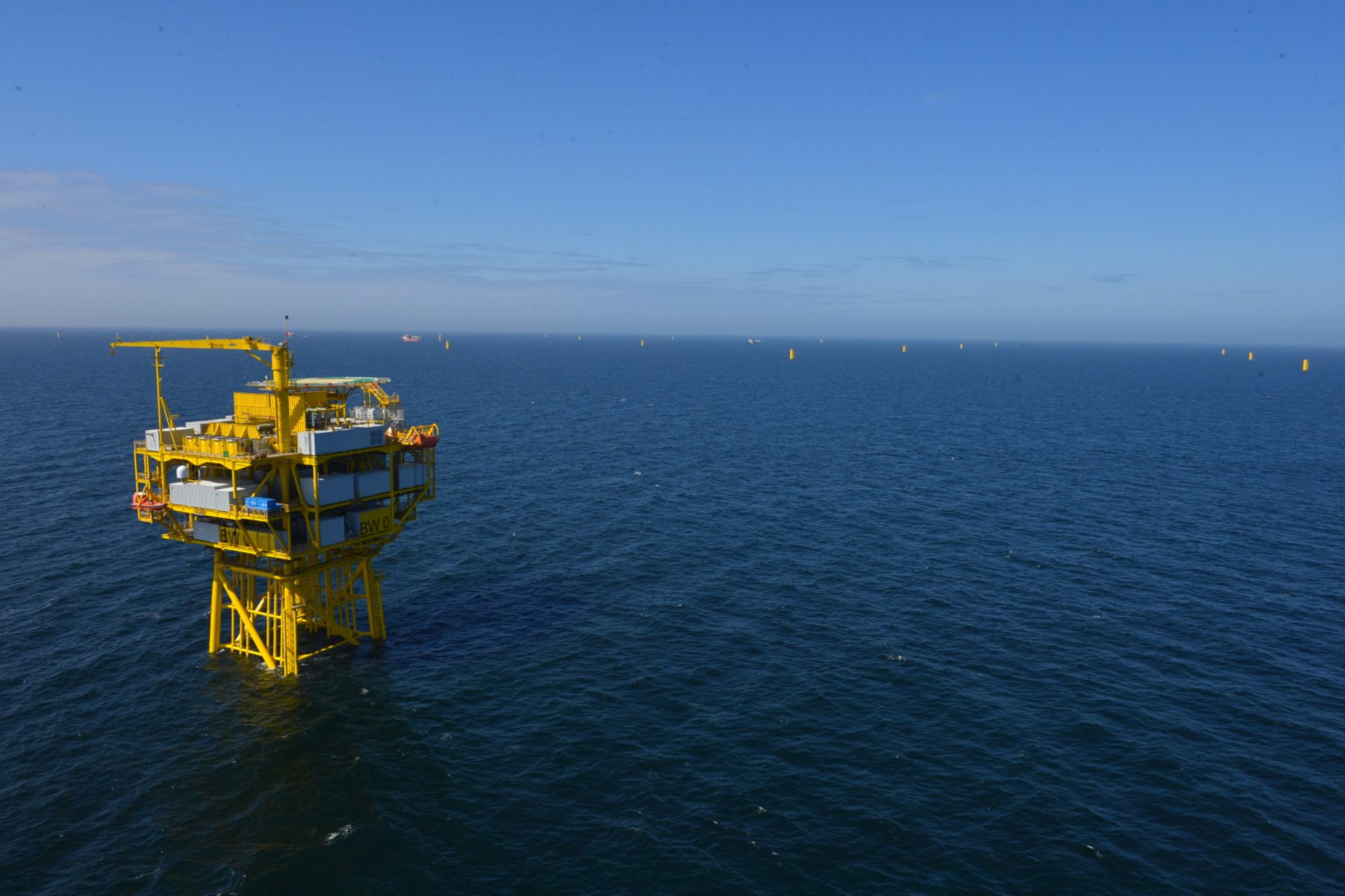

The initial testing of the link between Trianel Wind Farm Borkum’s transformation platform and TenneT’s transformation platform “DolWin 1” failed. “Due to technical problems, the attempt had to be aborted,” said Trianel spokesperson. As a result of initial testing that took place in late August only

1 minutes read

The initial testing of the link between Trianel Wind Farm Borkum’s transformation platform and TenneT’s transformation platform “DolWin 1” failed.

“Due to technical problems, the attempt had to be aborted,” said Trianel spokesperson.

As a result of initial testing that took place in late August only a minor damage at the wind farm’s platform occurred.

Alstom, the manufacturer of the transformer station is working on a repair schedule.

“The repair will cause a delay of a few weeks,” added Trianel .

They also added that the status of their 40-turbine wind farm is unchanged as they are waiting for the connection to the grid by the operator TenneT.

Advertisement

Reach the Offshore Wind industry in one go!

Offshore Wind is read by thousands of professionals every day.

Increase your visibility with banners, tell your story with a branded article, and showcase your expertise with a full-page company profile in our business directory.

CONTACT

Follow Offshore Wind on:

Daily Offshore Wind News in Your Mailbox

Join thousands of industry professionals who start their day with our newsletter.
